SPRING 2005 LAND APPLICATION OF BIOSOLIDS PROJECT
PROJECT REPORT
This report provides information on the Spring 2005 land application of biosolids (solids from the wastewater treatment process).
Biosolids are dewatered and stored for approximately 4-5 months in on-site storage bunkers. removed three times annually

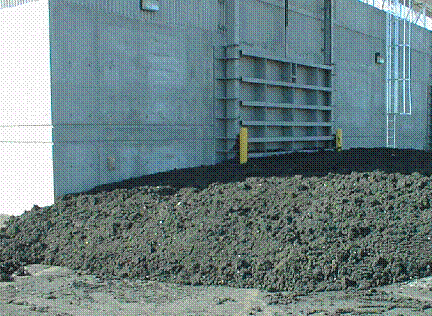

Picture 1: The picture at left is the material as it is
removed from the biosolids storage area. The material is loaded into
semi-trucks for transport.
Table 1. Schedule of the Project
Mobilization of Equipment |
2/27/05 |
Began transporting and applying biosolids |
2/28/05 |
Number of days worked |
11 days |
Number of rain days |
2 days |
Completion of project |
3/10/05 |

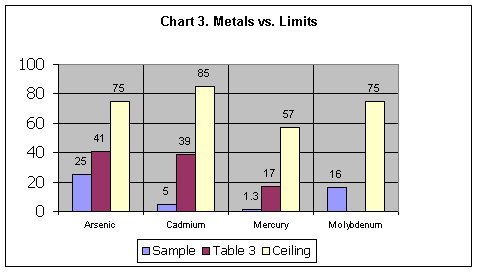

Charts 1 through 3 on this page illustrate the metals
concentrations as compared to the EPA’s ceiling limits (over these limits
land application is not allowed by the EPA) and Table 3 limits (a higher
quality limit set by the EPA). As shown, the City’s metals concentrations
in biosolids are considerably less than even the Table 3 limits. They’ve
been separated into three charts due to variance in scales. All EPA and Kansas
regulations and requirements were met during the Spring application.
Note: Molybdenum (at left) does not have any Table 3
limits.
The following bullets depict the specifics of the project:
· Number of farmers participating this spring 4 farmers
· Number of fields applied: 12 fields
· Average acreage per field: 27.5 acres
· Total acres applied to: 330.0 acres
· Cubic yards removed 3041.5 cu. yd.
· Cost/ cu. yd. (2004) $10.12
· Cu. yards billed at 2004 cost 1445.86 cu. yd.
· Cost/cu. yd. (2005) $10.62
· Cu. yards billed at 2005 cost 1595.64 cu.yd.
· Total expense for Spring application project $32,239.90
(5% retained for completion of annual report)
Nutriject Systems is the current contractor for the land
application of biosolids for 2005. They provide the removal, transport,
application, testing of soil and biosolids, annual reporting and
recordkeeping, and incorporation (where required) for each land application
event. We anticipate removal and application in July on harvested wheat ground,
hay or pasture; and a final application in November following harvest. The pictures at left show some of the application

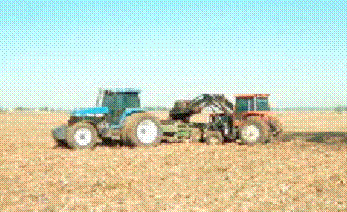

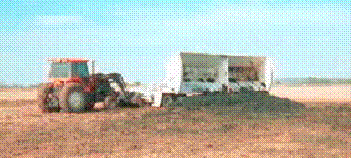

process including loading into the spreader (top), unloading of a transport
truck (middle), and the field as applied and before incorporation (bottom).
