TRAIL ROAD RELIEF SEWER (PROJ.# 1SS-204)
FINAL REPORT

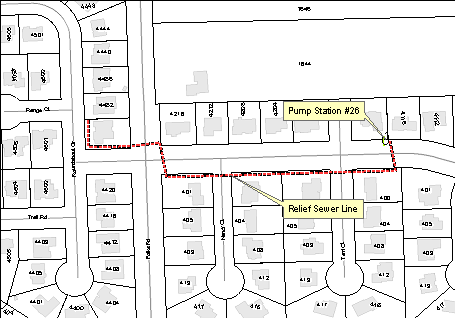

This report provides information regarding the recently completed Capital Improvement Project # 1SS-204, also known as the Trail Road Relief Sewer Project. A map of the project area is shown below.
General Project Information
The goal of the project was to
install a relief sewer that would enable the City to decommission Pump Station
# 26, located at 4118
Trail Road. PS 26,
installed in 1989 to serve development north of 6th Street between Monterey Way and Folks Road, was located in the front yard of 4118 Trail Road. (see photo #1). Unreliable
electrical service to the station caused basement flooding on several
occasions. Decommissioning of this station would result in substantial savings
in maintenance costs and utility (phone, electric) costs, remove a pump station
from a front yard location and improve system reliability. The relief sewer
would convey flows by gravity from the pump station wet well to a sewer system
on the west side of Folks
Road. Challenges
associated with this project
Photo #1
included trench depths, a thick shelf of granite rock, a wintertime construction schedule and excavation in an established neighborhood.
Table 1 presents information related to the schedule of the project.
Engineering Proposals Received |
12/19/03 |
Bids Opened |
08/17/04 |
Working Days Allotted |
40 |
Working Days Used |
73 |
Notice to Proceed Given |
11/03/04 |
Final Completion Date |
04/08/05 |
Table 1
Professional Engineering Consultants, P.A. (PEC) was selected as the consultant for the project. Meadows Construction Company was the low bidder on the project and was awarded the construction contract.
Graph 1 provides information on the engineering and construction costs of the project.
Graph 2 provides a breakdown of engineering costs.
|
|
Graph 1 Graph 2
Table 2 presents information regarding cost of the project
Engineer’s Estimate of Construction Cost |
$303,544 |
Construction Costs |
$395,088 |
Easement Costs |
$1 |
Engineering Costs |
$48,050 |
Change Orders |
2 |
Change Order Amounts (+/-) |
-($7,750)* |
Total Cost of Project |
$443,139 |
2003 Master Plan Projected Cost |
$260,000 |
Table 2
*Contractor was assessed liquidated damages in an amount sufficient to cover additional construction phase service costs (on-site inspection)
Project Photographs
|
|

PS 26 prior to development of the area Deep excavation in rock
|
|
Winter shutdown New sod after construction
Jim Stuit June 2005
